Routing Routing

Rte 233From Route 152 to Route 99 at Chowchilla via Robertson Boulevard.

Post 1964 Signage History Post 1964 Signage History

This routing remains as defined in 1963.

Note: Before Route 99 was a freeway what is now Route 233 would have terminated at Chowchilla Boulevard. Originally Chowchilla Boulevard would have had a junction with Robertson Boulevard north of the railroad tracks roughly where the "Chowchilla City Limit" sign is located now.
(Source: Gribblenation Blog (Tom Fearer): "California State Route 233")

A discussion of the Highways to Boulevards program during the March 2022 CTC meeting identified the following segment(s) as potential Highways to Boulevards conversion projects: Route 233 in the city of Chowchilla.
(Source: March 2022 CTC Agenda, Agenda Item 4.3)

Pre 1964 Signage History Pre 1964 Signage History

This was LRN 124, defined in 1933.

Status Status

Chowchilla Capital Preventative Maintenance Project (06-Mad-233 1.80/3.88)

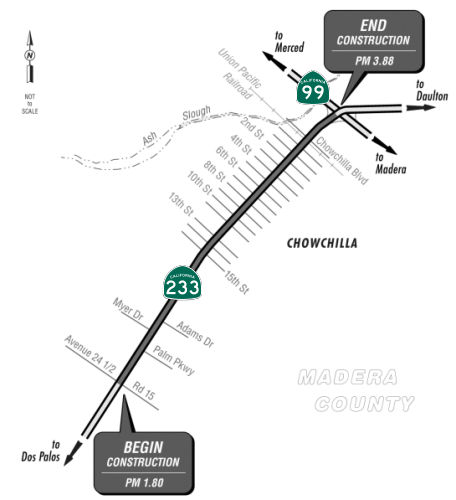

Chochilla CAPM ImprovementsIn March 2024, the CTC approved a request for an additional $300,000 (45.5% increase) in Pre-Construction Support, PA&ED phase, for the following SHOPP Pavement Preservation project: 06-Mad-233 1.80/3.88. PPNO 06-7095; ProjID 0619000224; EA 0W860. Route 233 In Chowchilla, from Avenue 24½ to Route 99. Outcome/Output: Rehabilitate pavement and upgrade Transportation Management System (TMS) elements, roadside signs, and guardrail, and construct Class 2 bike lanes, Americans with Disabilities Act (ADA) compliant curb ramps and sidewalks, bulbouts, and flashing beacons as complete streets and safety elements. Supplemental funds are needed to complete PA&ED. The project realized cost increases due to the addition of complete streets and safety elements. The project’s original scope proposed to rehabilitate the pavement and upgrade transportation management system elements, roadside signs, and guardrail.  In October 2023, this project was selected to receive Infrastructure Investment and Jobs Act funding to add complete street and safety elements.  In December 2023, the project was amended to incorporate complete street and safety elements along Route 233. The complete street elements consist of adding 2.2 miles of Class II bike lanes, construct 55 curb ramps/bulbouts, and 1,650 feet of sidewalk.  The safety elements  consist of adding and upgrading 2,300 feet of crosswalks, enhancing the visibility of the 27 crosswalks, and installing 20 flashing beacons.  Additional efforts to incorporate the complete street and safety elements will amount to  $300,000. The Department anticipates requesting allocation for the Plans, Specifications, and Estimate and Right of Way Support phases in August 2024.
(Source: March 2024 CTC Agenda, Agenda Item 2.5e.(12))

In October 2024, the CTC approved the following changes to an existing project in the 2024 SHOPP: 06-Mad-233 1.80/3.88. PPNO 06-7095; ProjID 0619000224; EA 0W860. Route 233 In Chowchilla, from Avenue 24 1/2 to Route 99. Rehabilitate pavement and upgrade Transportation Management System (TMS) elements, roadside signs, and guardrail, and construct Class 2 bike lanes, Americans with Disabilities Act (ADA) compliant curb ramps and sidewalks, bulbouts, and flashing beacons as complete streets and safety elements, and add fiber optic cable. Concurrent Greater than 20 percent PS&E and R/W Sup allocation under Resolution FP-24-18; October 2024. Note: Update the Existing Condition performance table to reflect the latest Automated Pavement Condition Survey (APCS). Allocation ($ × $1000): PA&ED $660; PS&E $980; R/W Sup $30; Con Sup $979; R/W Cap $228; Const Cap: $10,575; TOTAL $13,452.
(Source: October 2024 CTC Agenda, Agenda Item 2.1a.(1d) #7)

In October 2024, the CTC approved for future consideration of funding 06-Mad-233, PM 1.80/3.88. Chowchilla Capital Preventative Maintenance Project.  Rehabilitate pavement and upgrade Transportation Management System elements, construct Complete Streets elements and broadband on Route 233, in Madera County. (ND) (PPNO 7095) (SHOPP).  The project is located on Route 233 from PM 1.80 to PM 3.88, in Madera County. The Department proposes to update existing TMS elements, modify traffic signals, Rectangular Rapid Flashing Beacon systems, remove, replace, and modify existing traffic striping and pavement markers, upgrade existing roadside signs, update guardrails, and Asphalt Concrete dikes within the project limits, install Class 2 bikeway access, update curb ramps to current ADA standards, replace ADA curb ramps with bulb-outs, repair and replace damaged curb, gutter, and sidewalk in failed areas, add enhanced visibility crosswalks, add sidewalks, add and upgrade lighting, install bay parking, and add broadband to improve TMS communication. The project is currently programmed in the 2024 SHOPP. The total programmed amount which includes Right of Way (Support and Capital), and Construction (Support and Capital) is $13,452,000. Construction is estimated to begin in 2026-27. The scope, as described for the preferred alternative, is consistent with the project scope as programmed by the Commission in the 2024 SHOPP.
(Source: October 2024 CTC Agenda, Agenda Item 2.2c.(1) #9)

In October 2024, the CTC approved a request for $3,600,000 (267.3% increase) allocation in Pre-Construction Support, PS&E phase and $2,660,000 (8,766.7% increase) allocation in Right of Way (RW) Support phase, for the SHOPP Pavement Preservation project on Route 233, in Madera County.  (PPNO 06-7095; ProjID 0619000224; EA 0W860). 06-Mad-233 1.8/3.88. Allocation (Programmed, if different): PS&E $3,600,000 ($980,000); RW Sup $2,660,000 ($30,000).In March 2022, this project was programmed in the SHOPP for $980,000 in PS&E and $30,000 in RW Support for allocation in Fiscal Year 2023-24. In December 2023, the project was amended to update the scope by adding complete streets and safety elements through Infrastructure Investment and Jobs Act (IIJA) funds.  In March 2024, the project was amended again to update the scope by adding fiber optic cables through IIJA funds.  In June 2024, the project requested an allocation time extension for the PS&E and RW Support phases.  However, the request was deferred to the August 2024 meeting and approved for four months. In August 2024, the Department updated the estimate and reflected the need for  $3,600,000 in PS&E (267.3 percent over the programmed amount) and $2,660,000 in RW Support (8,766.7 percent over the programmed amount).  The project is scheduled to complete the PS&E and RW Support activities and be Ready to List by March 2026. The PS&E and RW Support estimates are greater than the current programmed amount due to the addition of complete streets and safety elements and broadband work. The scope of this project proposes to rehabilitate the pavement and upgrade transportation management system elements, roadside signs, and guardrail along an approximate two-mile segment of SR 233.  In December 2023, during the Project Approval and Environmental Document phase, an amendment was approved to incorporate complete streets and safety elements through IIJA funds.  The complete streets and safety elements that will be incorporated into the project consist of constructing 39 curb ramps, approximately one mile of sidewalk, 17 bulb-outs, and parking cutouts.  In addition, the project will install approximately 1.7 miles of Class II bicycle lanes, 1,260 feet of enhanced-visibility crosswalks, and 4 flashing beacons.  In March 2024, another amendment was approved to incorporate two miles of fiber optic cables through IIJA funds. The nature of this work is very detail-oriented and is very time-consuming.  This work will also require a significant amount of coordination with the City and property owners due to the reduction in lane width and loss of on-street parking.  In addition, the project will require additional traffic handling.  The addition of the complete streets and safety elements and broadband work will require additional surveys and design efforts. Initially, right of way efforts were very minimal with no parcels being impacted.  The addition of the complete streets and safety elements and fiber optic cables has triggered the need for right of way and utility work.  The proposed work will impact 73 parcels. Most of this work consists of temporary construction easements that are needed to construct the pedestrian features.
(Source: October 2024 CTC Agenda, Agenda Item  2.5d.(3))

Other WWW Links Other WWW Links

Statistics Statistics

Overall statistics for Route 233:

Pre-1964 Legislative Route Pre-1964 Legislative Route

In 1953, Chapter 1787 defined LRN 233 as: “(a) High Street, Oakland, between [LRN 69] and [LRN 5]; (b) [LRN 227] near the intersection of Park Boulevard, Oakland to [LRN 75] near Lafayette”. Preliminary studies were completed in 1956 covering the location for this future freeway. On December 19, 1956, after various public meetings and a hearing before the Highway Commission, the last gap in the route was adopted and declared a freeway. This future facility will consist of initially four lanes, future six lanes, and starting at the Mountain Boulevard Freeway in Oakland, will traverse Shepherd Canyon and tunnel some 1,400 feet through the Oakland hills. It will span the Redwood Canyon in Contra Costa County and traverse the range of hills easterly thereof entering and crossing the Moraga Valley just north of the present town site. It traverses close to St. Mary's College and terminates at a junction with Route 24 at Pleasant Hill Road. In 1957, Chapter 52 renumbered this definition as LRN 235. It does not appear to have ever been constructed, but corresponds to an unconstructed portion of Route 77.

However, Chapter 1791 also defined LRN 233 as “[LRN 83] near Sierraville to [LRN 21] near Vinto, via Loyalton. Provided, however, that Section 600 of the Streets and Highways Code shall be applicable to the route added to the State Highway System by this section the same as if said route had been added by the Collier-Burns Highway Act of 1947, and the Department of Public Works shall not be required to maintain any portion of said route until the same has been laid out and constructed as a state highway”

In 1955, Chapter 1488 removed the language relating to Section 600.

This was part of Route 49.
